Most people approach ESS selection the wrong way.
The first question is usually: "How many kWh do I need?" That's a reasonable question — but it's the last question, not the first.
Before capacity, there are four variables that determine which type of system is even viable for your project: grid conditions, installation environment, maintenance capability, and project scale. Get these wrong, and no amount of spec-comparing will save you from a mismatched solution.
This article gives you a practical framework for making that call — across residential, distributed, and containerized ESS — before you waste time on datasheets.
The Real Selection Logic: Four Questions Before You Compare Specs
Here's what most selection guides skip: the three ESS categories don't differ mainly in capacity. They differ in who operates them, where they're installed, and what the grid looks like.
Ask these four questions first.
1. What's the grid situation? Strong grid, weak grid, or no grid at all? A fully off-grid site has fundamentally different requirements from a grid-connected commercial building, even if the capacity numbers look similar.
2. What's the installation environment? Is this a residential rooftop project, a commercial building with a dedicated electrical room, or an open industrial site? Space constraints, weatherproofing requirements, and access conditions all affect what's deployable.
3. Who maintains it? A homeowner with a mobile app is not the same as a facility manager with an in-house electrical team. System complexity should match the operator's actual capability — not their optimistic self-assessment.
4. What's the rough capacity range? Not an exact figure. Just an order of magnitude. Under 30 kWh? Between 50 kWh and a few hundred kWh? Or are you looking at 1 MWh and above?

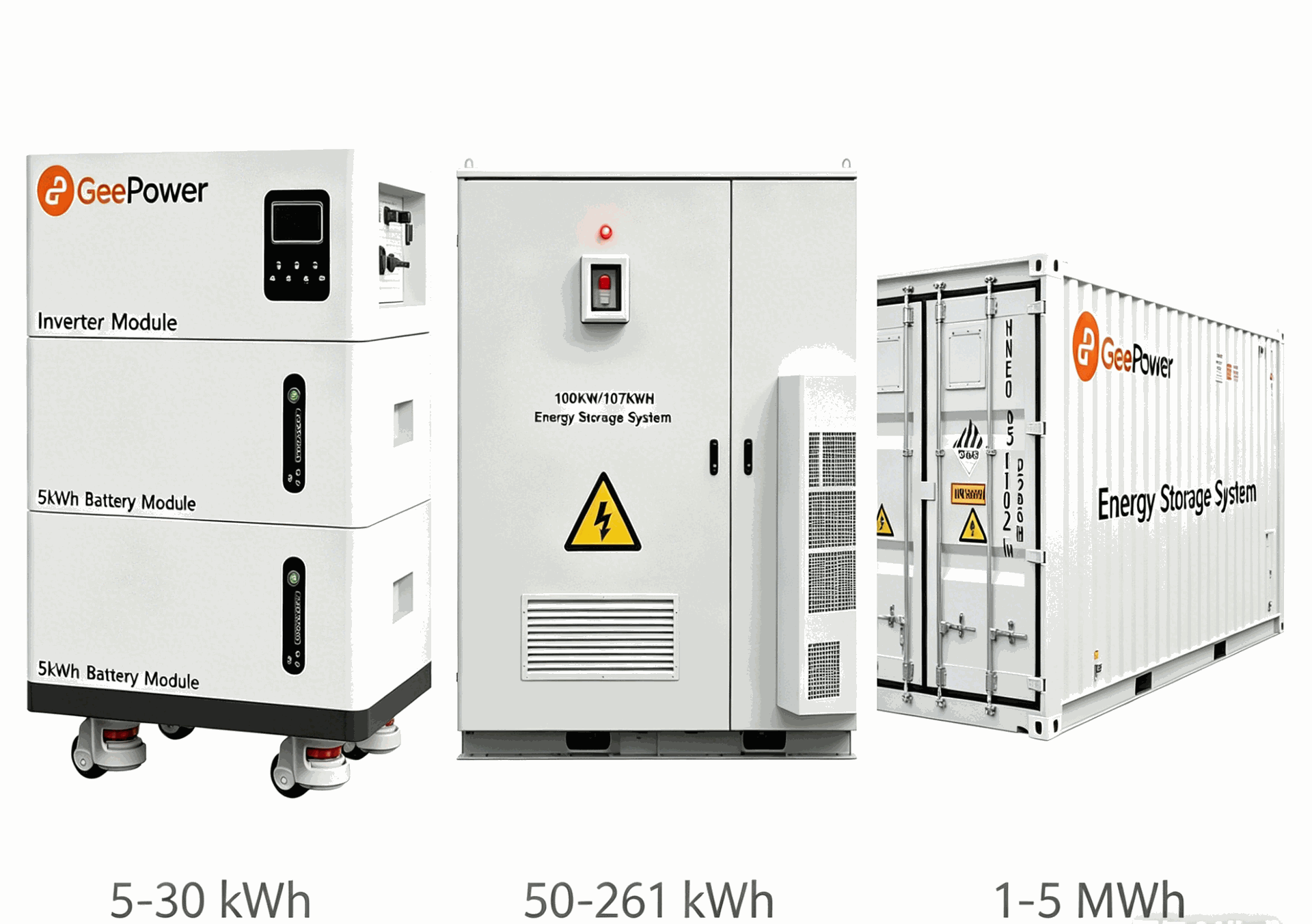

GeePower's product line runs from 5 kWh residential systems up to 5 MWh containerized configurations. Those aren't just capacity increments — each tier represents a different system architecture, integration requirement, and deployment model.
Once you've answered these four questions, the selection logic becomes considerably less ambiguous.

Residential ESS: Grid-Connected, Household-Scale, Operator-Friendly
If your project checks these three boxes simultaneously — capacity under 30 kWh, grid connection available, end user is a homeowner or light commercial operator — residential ESS is the right starting point.
The core value proposition here is well-established: time-of-use optimization, solar self-consumption, and backup power during outages. What's less obvious is the boundary.
Residential ESS makes sense when:
- The daily energy demand is household-scale or light commercial (think small retail, a café, or a home office with critical loads)
- The end user can interact with a scheduling interface — setting off-peak charge windows, monitoring via app
- The installation site allows for wall-mounted or floor-standing units with standard electrical connections
It stops making sense when:
- Continuous load requirements exceed what a 30 kWh system can realistically cover
- There's no grid connection and the site demands true off-grid autonomy
- The operator has no capacity for even basic system interaction

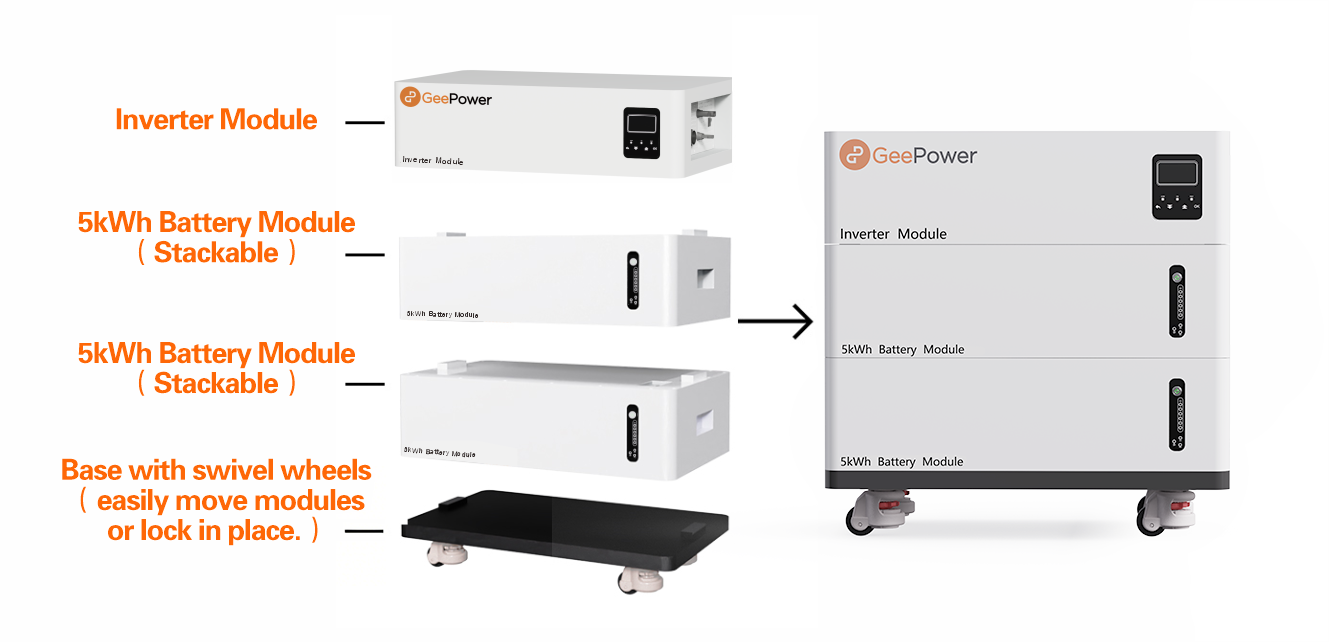

GeePower's TERRA A series covers this segment with capacities from 5 kWh to 30 kWh, built on LFP chemistry with modular stackable expansion. One practical detail worth noting from the official product documentation: if you plan to expand capacity later, additional modules are recommended to be added within 6 months of the initial installation. That's not just a product note — it's relevant for project planning when a client expects to scale up.

The system includes an integrated inverter, dual MPPT, smart scheduling, and built-in fire suppression. For residential and small commercial projects, it handles the full use-case stack without requiring a separate BMS or inverter procurement.
→ [Explore the TERRA A Series for residential and light commercial projects]
Distributed ESS: When Grid Conditions Are Unreliable or Capacity Is Commercial-Scale
Distributed ESS covers a broader and arguably more complex set of scenarios than residential. Two situations point clearly toward this category.
Scenario one: weak grid or off-grid projects.
Unstable grid supply is common in certain markets — rural electrification, remote industrial sites, agricultural operations, and some emerging-market urban deployments. These projects can't rely on the grid as a reliable backstop. The ESS needs to function as a primary energy management layer, not just a supplemental buffer.
In these cases, the system architecture must handle longer discharge durations, tighter control logic, and potentially full island-mode operation. A residential unit is not designed for this.
Scenario two: commercial capacity requirements in the 50–261 kWh range.
Commercial buildings, factories, solar self-consumption projects, and distributed generation installations often land in this band. The load profiles are more complex, the electrical integration requires more care, and the economics are driven by peak shaving and load shifting rather than household tariff arbitrage.
GeePower's cabinet-format commercial ESS covers this range — from 50 kWh up to 261 kWh per unit — with integrated inverter, intelligent BMS, and a design optimized for fast deployment and simplified commissioning. The all-in-one cabinet format matters here: it reduces installation complexity compared to assembling separate components, which is relevant when you're working across multiple distributed sites.
When distributed ESS stops being the right answer: if a single-point capacity requirement exceeds 261 kWh, or if the project requires coordinated multi-point dispatch at utility scale, the architecture shifts.
→ [Commercial ESS & Distributed ESS Solution overview]
Containerized ESS: When the Project Exceeds 1 MWh or Requires Full System Integration
At 1 MWh and above, the selection question changes character.
It's no longer just about capacity. It's about system integration complexity, thermal management at scale, multi-layer safety architecture, and the operational infrastructure needed to run the system reliably over a 10+ year project lifecycle.
A containerized ESS is not a "bigger cabinet." It's a different class of engineered system.
Projects that typically require containerized ESS:
- Large-scale peak shaving for industrial sites with significant demand charges
- Grid-side or utility-adjacent storage deployments
- Microgrid installations where the battery is the primary grid-forming asset
- Renewable energy projects (solar or wind) requiring substantial co-located storage
GeePower's containerized ESS covers 1 MWh to 5 MWh, with battery, PCS, BMS, and EMS fully integrated in an outdoor-rated enclosure. The system includes an advanced thermal management system and multi-layer fire protection architecture — both of which are non-negotiable at this scale, not optional add-ons.
One structural difference from smaller systems: these projects require professional commissioning and ongoing technical maintenance. If the project owner doesn't have an in-house technical team or a service contract in place, that needs to be resolved before equipment selection.
The other implication: containerized ESS projects typically involve an engineering consultation phase before procurement. Selecting the system and configuring the system are two separate conversations.
→ [Containerized ESS project details]
A Practical Decision Framework: Match Your Project to the Right Architecture

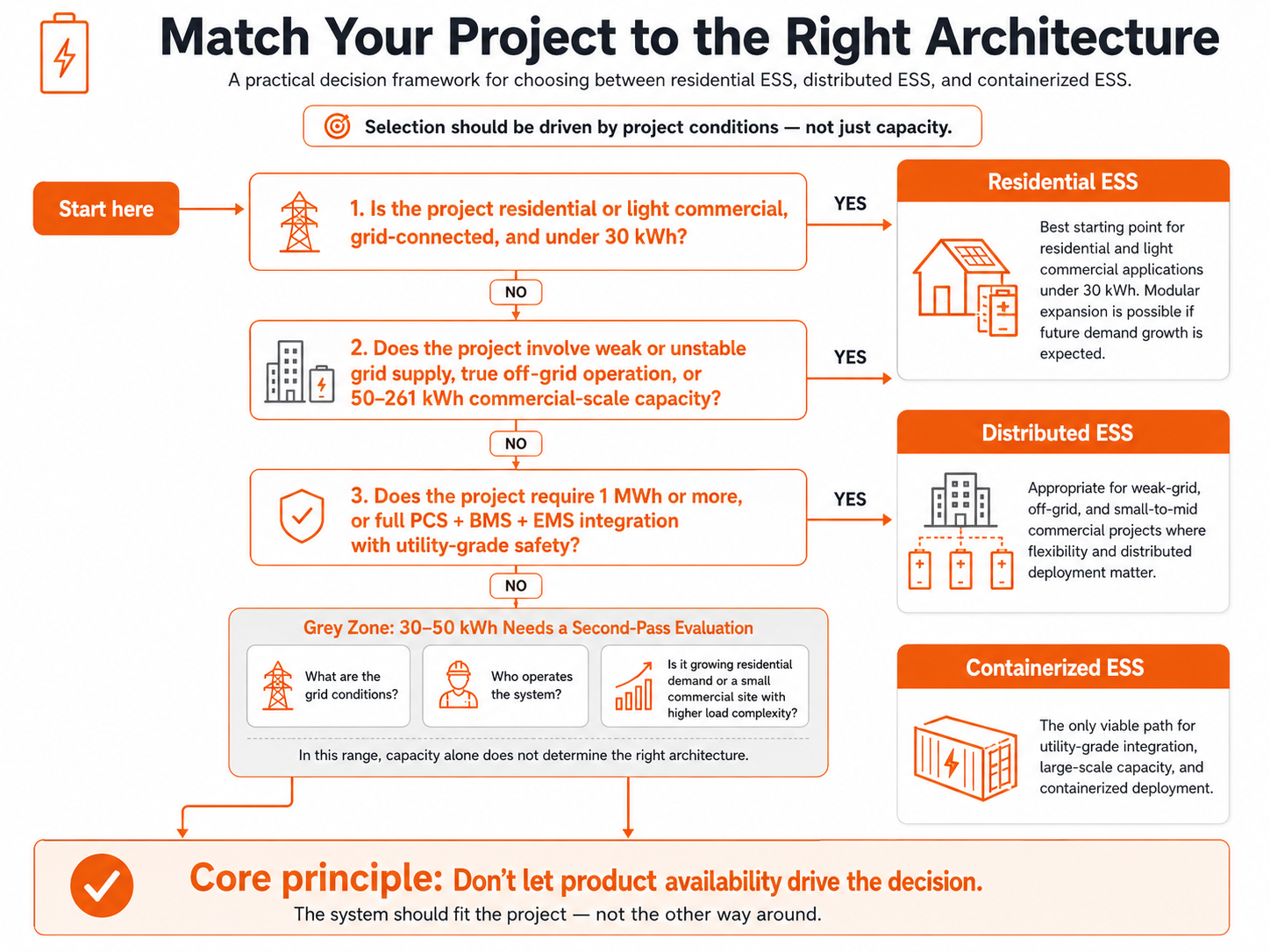

Here's how the selection logic consolidates:

If your project is residential or light commercial, grid-connected, and under 30 kWh — residential ESS is the right starting point. Modular expansion is possible if future demand growth is anticipated.
If your project involves weak or unstable grid supply, true off-grid requirements, or commercial-scale capacity between 50 kWh and 261 kWh — distributed ESS is the appropriate architecture.
If your project requires 1 MWh or more, or demands full PCS + BMS + EMS integration with utility-grade safety — containerized ESS is the only viable path.
The grey zone sits between 30 kWh and 50 kWh. Projects in this range need a second-pass evaluation: What are the grid conditions? Who operates the system? Is this genuinely residential-scale with growing demand, or is it a small commercial site with load complexity that exceeds what a residential system handles cleanly? Those answers determine which direction to go — not the capacity number alone.
One consistent principle across all three categories: don't let product availability drive the decision. The system should fit the project, not the other way around.
Not Sure Which Architecture Fits? Start With the Project, Not the Datasheet
The framework above covers the clear cases. Real projects often have variables that don't fit neatly into a three-option grid.
Grid conditions aren't always clearly documented. Capacity requirements are sometimes estimates. Maintenance capability is often overstated in early project conversations.
If you're working through a project and the architecture isn't obvious, that's a normal position to be in — not a gap in your knowledge.
GeePower's team works with distributors, EPCs, and project developers at the early-stage selection phase. Tell us your project capacity and application scenario, and we'll recommend a suitable ESS architecture.
Start Your Project Consultation →
