How to Compare C&I BESS Quotes Like-for-Like: A Practical Evaluation Checklist

26 août 2026 par
How to Compare C&I BESS Quotes Like-for-Like: A Practical Evaluation Checklist
Hugo Zhang

Part 2 of 2. Part 1 of this guide covers $/kWh pitfalls, system scope, energy normalization and PCS/EMS comparison. This part covers compliance, warranty, commercial terms, how to use the comparison matrix, and the red flags worth checking before you make a final call.

→ [Back to Part 1: Why C&I BESS Quotes Vary So Much — What to Check Before Comparing Price]

Getting scope, energy and integration onto the same basis is necessary. It isn't sufficient.

Two quotations can look comparable on hardware and still produce very different project outcomes — depending on what compliance documentation is actually available, how warranty claims are handled in practice, whether commissioning is included in the price, and what the commercial terms mean for your actual landed cost.

Steps 4, 5 and 6 below address those gaps. The comparison matrix and red flag checklist that follow are designed to make the full normalization process manageable across multiple suppliers.

Step 4: Check What Compliance the Quote Actually Covers

Don't compare quotations by counting certification logos on a product page. The right question is:

Does this configuration meet the compliance requirements for this market and this project?

A supplier may hold a certificate for one product configuration. That doesn't automatically cover the exact configuration in your quotation. The target market adds another layer — a system prepared for one country may need modification before it can be used in another. And depending on the project, relevant requirements may include battery transport documentation, PCS standards, grid-connection documentation and project-specific compliance items — not just a product conformity mark.

Ask a specific question instead of a general one:

"Which documents and compliance requirements apply to the exact system you're quoting, for this project, in this market?"

That produces a useful answer. "Do you have CE / IEC / UKCA?" usually doesn't.

Step 5: Normalize Warranty, Commissioning and Technical Support

Two quotations with similar hardware and normalized scope can still create very different workloads after delivery.

Warranty. "5-year warranty" is not enough information. You need to know what triggers a valid claim, what the capacity or performance thresholds are, what's excluded, and what the actual claim process looks like. A warranty that's difficult to invoke in practice is worth less than it appears on paper.

Commissioning. Is it included or optional? Remote or on-site? Is there an additional charge? For many EPCs and integrators, the answers here are more commercially significant than a small gap in hardware price. A cheaper system that requires the EPC to handle commissioning independently changes the total cost of delivery.

Technical support. Confirm what the supplier actually covers after shipment: PCS configuration, EMS setup, communication, troubleshooting, remote diagnostics. The question isn't whether one supplier promises better service. It's whether the support scope is defined clearly enough for your project team to plan around it.

Step 6: Put the Commercial Terms on the Same Basis

Commercial terms can make a cheap quotation appear cheaper than it really is. Before ranking suppliers by price, move every quotation to the same commercial boundary.

Key items to align:

  • Incoterm (EXW, FOB, CIF, DDP)
  • Freight and insurance
  • Packaging
  • Payment terms
  • MOQ and project quantity
  • Lead time
  • Spare parts availability
  • Customization charges
  • Commissioning fees

A USD 60,000 EXW quotation is not directly comparable with a USD 65,000 CIF quotation. The second supplier may already be covering freight and additional services. Adjust to the same delivery basis before drawing any conclusions on price.

Using the Comparison Matrix

The most reliable way to evaluate several suppliers is a structured table that covers the same fields across every quotation. The matrix organizes three areas.

Technical scope: system boundary, nominal and usable energy, continuous power, C-rate, PCS brand and model, EMS functions, communication protocols, cooling type, fire protection.

Compliance and support: transport documentation, market compliance coverage, grid-connection requirements, commissioning scope, warranty conditions, technical support terms, spare parts availability.

Commercial terms: Incoterm, freight, payment terms, order quantity, lead time, customization scope, exclusions.

Five steps to use it effectively

Step 1: Fill in what each supplier actually includes.

Use the quotation, datasheet and written clarifications — not assumptions. If something is unclear, mark it Unspecified. That's useful data in itself, and it flags where a follow-up question is needed before the comparison is complete.

Step 2: Identify missing required scope.

If Supplier A excludes the PCS and Supplier B includes it, you can't call Supplier A cheaper without pricing the gap. Confirm whether the PCS is required for the project and what it adds to the total before drawing any conclusions.

Step 3: Add missing scope back into the cost.

Apply the same logic to freight, commissioning, EMS, compliance work and any other required items. The adjusted figure reflects what the project actually costs from that supplier — not what they chose to show on the first page.

Step 4: Remove value for features the project doesn't need.

Supplier C may include EMS functions or equipment that's irrelevant to the operating mode. A higher price isn't justified by more equipment if the project won't use it. Only project-relevant scope should influence the final comparison.

Step 5: Compare remaining project risk.

When two normalized costs are close, the differentiator is uncertainty. Is compliance documented for the exact configuration and market? Is integration scope clearly defined? Who handles commissioning? Are warranty conditions specific enough to rely on? Is the lead time credible?

At this point, you're comparing procurement options — not product prices. That's the right level to make the final call.

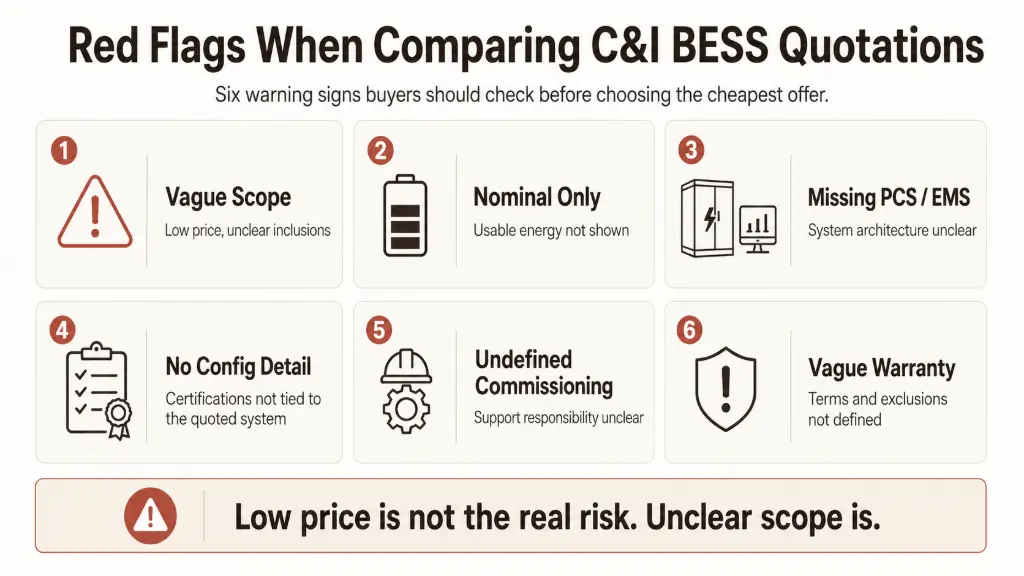

Red Flags Before You Choose the Cheapest Quote

Price is significantly lower, but scope is vague.

A low number isn't useful if you can't confirm what it includes. Push for a clear system boundary before treating the quotation as real.

Only nominal capacity is shown.

Ask for usable capacity and the SoC operating assumptions. The gap between nominal and usable can be substantial — and it changes the $/kWh picture significantly.

PCS or EMS information is missing.

A "complete ESS" quotation should define the system architecture. An evasive response to a direct question is itself a signal worth noting.

Certifications are listed without configuration details.

A certificate for one product configuration doesn't automatically apply to another, or to a different target market. Confirm coverage for the exact system being quoted.

Commissioning responsibility is undefined.

Clarify what the supplier handles and what the EPC must cover independently. Unresolved at quotation stage, this becomes a project management problem later.

Warranty terms are vague.

"Five-year warranty" needs conditions, performance thresholds and a claim process behind it. If those aren't available upfront, the coverage may not deliver what it appears to promise.

Final Decision: Fit-for-Purpose Value, Not Sticker Price

The lowest quotation may be the right choice. But only after confirming it's genuinely comparable.

The decision sequence:

Quoted Price → Normalized Comparable Cost → Fit-for-Purpose Value

The final question shouldn't be: which supplier gave me the lowest price?

It should be:

Which quotation delivers the required technical, compliance and support scope for this project — with the least unnecessary cost and an acceptable level of risk?

That's a more reliable basis for choosing a C&I BESS supplier.

FAQ

EXW, FOB, CIF and DDP assign different logistics responsibilities and costs to buyer and seller. An EXW price excludes freight, insurance and export handling. A CIF price covers freight and insurance to the named port. Comparing these directly without adjustment produces a misleading cost gap. Move every quotation to the same Incoterm basis — or at minimum, add estimated freight to EXW quotations — before ranking by price.

Not automatically. Once technical scope is comparable, you should still assess integration risk, compliance readiness, commissioning clarity, warranty conditions, lead time and technical support capability. Two quotations with similar normalized costs can carry very different levels of project risk.

When it includes something the project actually needs: more usable energy, required PCS capability, appropriate EMS functions for the operating mode, confirmed compliance for the target market, commissioning support, or clearly defined warranty coverage. A higher price is not worth paying for unused functions, oversized equipment or brand premium that doesn't serve this specific project.

PCS exclusion is the most frequent — particularly in battery-only cabinet quotations compared directly against all-in-one AC systems. Commissioning scope and compliance documentation are the next most common omissions. These gaps typically aren't apparent from the headline price and specification, which is exactly why the normalization process in Parts 1 and 2 of this guide exists.

C&I BESS Quote Comparison Matrix
